Al Maktoum International Airport: What Dubai Promised on DWC, and What It Has Actually Delivered

Al Maktoum International Airport: What Dubai Promised on DWC, and What It Has Actually Delivered

Dubai has been promising a five-runway, 260-million-passenger mega-airport at Al Maktoum International (DWC) since 2013. Three completion dates have already come and gone. A fourth is now on the books for 2032, and Dubai Airports says this attempt is different because the financing, the contracts and the machinery are already committed on site. This tracker sets out exactly what Dubai has promised, when it promised it, and what has actually landed on the ground in Dubai South, so investors, contractors and tenants around DWC can weigh the current 2032 target against the project's own track record.

A Project With Three Broken Deadlines Behind It

The expansion of Al Maktoum International was first announced around September 2013, when Dubai Airports said a $32 billion phase-one build would lift the airport's capacity from 5 million to 120 million passengers a year. By 2015, Khalifa Al Zaffin, then executive chairman of the Dubai Aviation City Corporation, told the corporation's Via Dubai newsletter that the phase would be finished by the first quarter of 2022, with capacity rising to 130 million passengers. Around the same period, Dubai Airports chief executive Paul Griffiths and then Emirates president Tim Clark separately pointed to 2025 instead (Gulf News, 2015).

Neither date held. The project was frozen in 2019 amid financing pressure and a broader slowdown in Dubai's economy, and the pause was extended by the COVID-19 pandemic. For the best part of five years, DWC's mega-terminal existed mainly as a master plan rather than a construction site.

The reset came in April 2024, when Sheikh Mohammed bin Rashid Al Maktoum approved a new AED128 billion ($35 billion) design for the DWC passenger terminal, describing an airport with five parallel runways, 400 aircraft gates and an eventual capacity of 260 million passengers and 12 million tonnes of cargo a year. Sheikh Ahmed bin Saeed Al Maktoum, chairman of Dubai Aviation City Corporation, said at the time that the first phase would be ready within ten years (Dubai Media Office, April 2024). That first phase timeline has since been firmed up to 2032, roughly eight years out from the announcement rather than ten.

Promised vs Delivered: The Full Record

The table below lines up every public commitment Dubai has made on DWC against what has actually happened since.

Year announcedWhat was promisedPromised deliveryWhat actually happened
2013 to 2014$32bn phase-one expansion; capacity from 5 million to 130 million passengers a yearQ1 2022Never completed. Griffiths and Clark later cited 2025 instead; that date also slipped.
2019Continuation of the original phase-one planN/AProject frozen due to financing pressure and an economic slowdown.
2020 to 2023N/AN/APause extended by the COVID-19 pandemic; limited visible construction activity.
April 2024New AED128bn ($35bn) terminal design; 5 runways, 400 gates, up to 260 million passengers a yearFirst phase within 10 years (about 2034)Design and construction formally approved by Sheikh Mohammed; site works begin.
November 2025UK Export Finance $3.5bn expression of interest; Emirates commits up to $12bn to its own DWC facilitiesSupports the 2032 first-phase targetFirst foreign financing interest confirmed at Dubai Airshow 2025.
June 2026Dh13bn ($3.5bn) in contracts awarded; construction phase formally starts2032 first phaseConfirmed by Dubai Media Office; earthworks and piling under way.
August 2026A further Dh55bn ($14.9bn) in contracts by year-end 20262032 first phase17,000 piles driven, 45 million cubic metres of earth moved, 10 million work hours logged, about 9,000 workers on site rising toward 120,000 at peak.
September 2026Second runway as the next infrastructure milestoneEnd of 2027New, specific near-term date confirmed; 2032 first-phase target and 150 million passenger capacity reaffirmed.

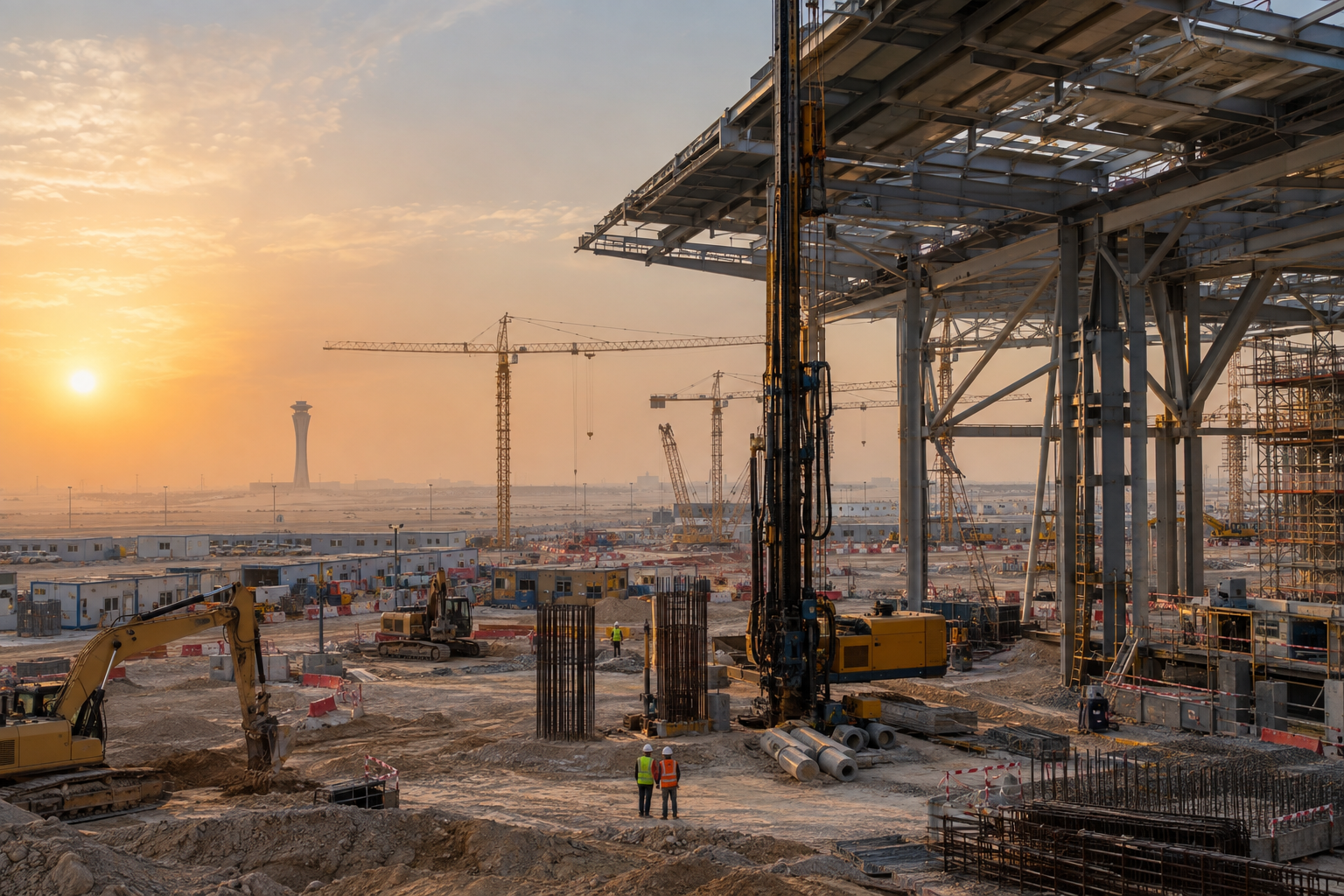

What Is Actually Sitting on the Site in Dubai South

Away from the announcements, Dubai Airports has published specific, checkable construction figures. As of late August 2026, Griffiths said the project had logged 10 million work hours over the previous 15 months, driven 17,000 piles into the ground, and moved 45 million cubic metres of earth. About 9,000 workers were on site, a number Dubai Airports expects to rise to roughly 120,000 at peak construction (The National, August 26, 2026). At a Government of Dubai Media Office briefing on September 11, 2026, Griffiths added that the terminal will be developed around eight nodes, each adding roughly 32 million passengers of capacity, so infrastructure can be built out progressively as demand grows rather than all at once (Dubai Media Office, September 2026).

Quick Facts: DWC as of September 2026

  • Total approved budget: AED128 billion, about $35 billion, approved April 2024
  • Contracts under construction: Dh13 billion (about $3.5 billion), with Dh55 billion (about $14.9 billion) more due by end of 2026
  • Construction activity logged: 10 million work hours, 17,000 piles, 45 million cubic metres of earth moved, over the prior 15 months
  • Workforce: about 9,000 on site now, expected to reach up to 120,000 at peak
  • Next milestone: second runway, due by the end of 2027
  • First-phase opening: 2032, for 150 million passengers a year
  • Full build-out: up to 260 million passengers and 12 million tonnes of cargo a year, five runways, no public date yet

The Money Behind the Steel

The Dh13 billion already under construction and the Dh55 billion pending by year-end 2026 sit inside the wider AED128 billion ($35 billion) budget Dubai approved in April 2024. Two external financing commitments have been layered on top since. UK Export Finance issued a $3.5 billion expression of interest at the Dubai Airshow in November 2025, the first foreign financing interest in the project, intended to open the door for British contractors and suppliers (The National, November 18, 2025). At the same event, Emirates chairman Sheikh Ahmed bin Saeed said the airline itself would invest up to $12 billion in its future home at DWC, covering facilities from catering to aircraft hangars.

Why the Second Runway Date Is the One to Watch

A 2032 opening is six years away, far enough out that it is difficult for anyone outside Dubai Airports to verify progress against it in real time. The second runway, due by the end of 2027, is a different kind of commitment. It is close enough to check against physical progress within the next 18 months, and Griffiths has called it explicitly the next major milestone for the project.

flydubai's planned move of five or six aircraft to DWC, potentially as early as 2027, is tied to that same runway coming online (Gulf News, September 2026). If the second runway and the flydubai move land on schedule, that is a far stronger signal for the 2032 first-phase date than any announcement made so far. If either slips, it is reasonable to treat 2032 with the same caution that Q1 2022 and 2025 deserved in hindsight.

What This Means for Businesses Around Dubai South

DWC's construction pace is already shaping activity well beyond the airport fence. Property transactions and rents in Dubai South have both climbed as the expansion has moved from announcement to visible construction, and that link between airport progress and land value is likely to tighten further as the 2027 runway date approaches. For logistics, hospitality and aviation-services firms weighing a move into Dubai South now, the practical planning horizon is not the 260-million-passenger endpoint. It is whether the Dh55 billion in contracts due this year gets awarded on schedule, and whether the second runway opens on time in 2027.

Editor's Note

This article is compiled from desk research using primary and verified secondary sources, including the Government of Dubai Media Office, on-record statements from Dubai Airports chief executive Paul Griffiths, and reporting from Gulf News, The National and Khaleej Times. No live interview was conducted for this piece. Figures on contract values, workforce size and construction progress are as disclosed by Dubai Airports and Dubai Media Office; they are official project statements rather than independently audited totals.

Read Also

Frequently Asked Questions

When will Al Maktoum International Airport (DWC) actually open?

The first phase is scheduled to begin operations in 2032, with capacity for 150 million passengers a year. This is the date Dubai Airports has confirmed most recently, as of September 2026. Full build out to 260 million passengers a year across five runways is planned for well beyond 2032, with no public completion date yet attached to that later stage.

How much has Dubai actually spent on DWC so far?

Dubai Airports chief executive Paul Griffiths said in August 2026 that Dh13 billion (about $3.5 billion) worth of contracts were already under construction, with a further Dh55 billion (about $14.9 billion) due to be awarded before the end of 2026. The wider project carries an AED128 billion ($35 billion) budget approved in April 2024, and Emirates has separately committed up to $12 billion of its own capital toward facilities at the new terminal.

Why did the original 2022 completion date fail?

The first version of the DWC expansion, announced around 2013 to 2014 with a $32 billion budget, targeted completion by the first quarter of 2022. That timeline slipped to 2025, and the project was then frozen in 2019 due to financing pressure and a broader economic slowdown, a pause that COVID-19 extended further. Dubai did not restart the project at scale until April 2024, when a new AED128 billion master plan and terminal design were approved.

#Al Maktoum International Airport #DWC #Dubai Airports #Paul Griffiths #Dubai South #Al Maktoum airport 2032
